Lucknow Development Authority’s Anant Nagar Yojana on Mohan Road is much bigger than the residential plots currently being offered under Phase V.
The latest Phase V release in Ashish Khand is important for buyers looking for an authority-developed plot in Lucknow, but LDA’s own project presentation shows that these plots are intended to become part of a much larger integrated township — with residential plots, group housing, affordable housing, commercial facilities, large green areas, an education hub and planned urban infrastructure.
LDA’s official project page describes Anant Nagar as an approximately 785.02-acre urban development along Mohan Road, combining residential, educational and commercial uses.
For a buyer, that larger vision is attractive. But it also creates the most important question around Anant Nagar:
How much of the planned township will actually be developed, occupied and functional during your holding period?
That distinction matters more than any promotional promise.
Concept of Anant Nagar
The story of LDA’s Anant Nagar Yojana goes back to around 2012, when the idea of developing a large township along Mohan Road first emerged. Over the following years, land acquisition, compensation and planning activities progressed, and by 2022–23 the project was redesigned as a modern sector-based township inspired by the Chandigarh–Panchkula planning model. In 2023, the approximately 785-acre layout received approval, while environmental clearances and infrastructure-related work moved forward in 2024. On 4 April 2025, the project was officially launched as Anant Nagar Yojana. The broader township plan includes eight sectors, residential plots, group housing, EWS and LIG housing, commercial areas, an education hub and large green spaces. Phase I and Phase II lotteries were conducted in 2025, while Phase III and Phase IV plot allotments progressed in 2026. By September 2026, Phase V in Ashish Khand had opened with 460 plots, with registration stated to remain open until 9 September. This means Anant Nagar is no longer just a proposed scheme; it is now an actively developing LDA township, although it cannot yet be considered a fully developed project.
What is available in Anant Nagar Phase V?
Phase V has been opened for residential plots in Ashish Khand.

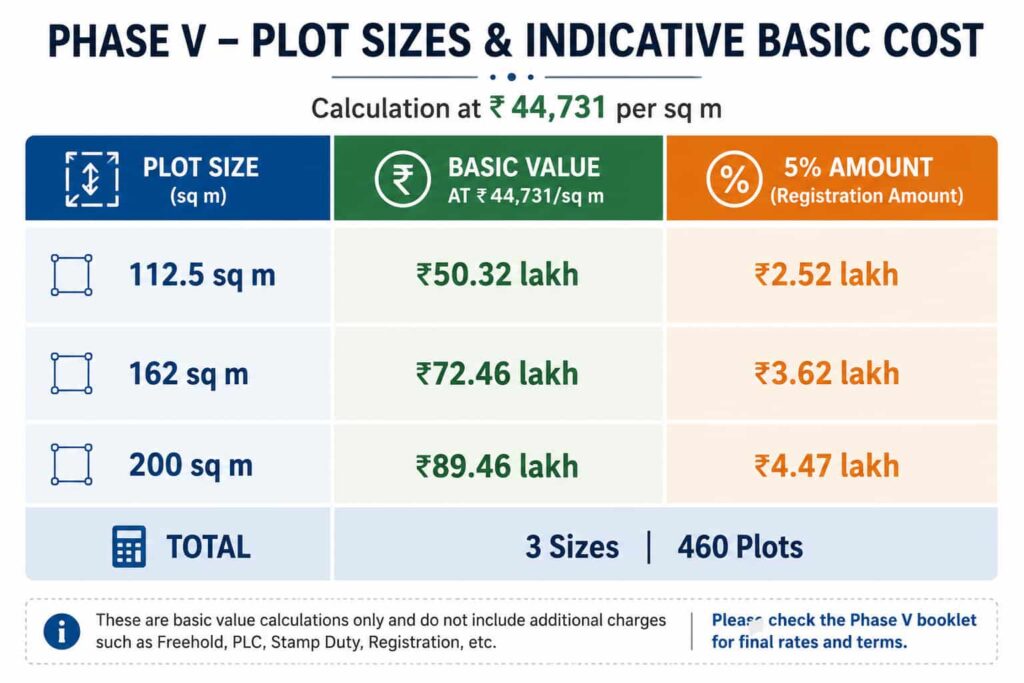

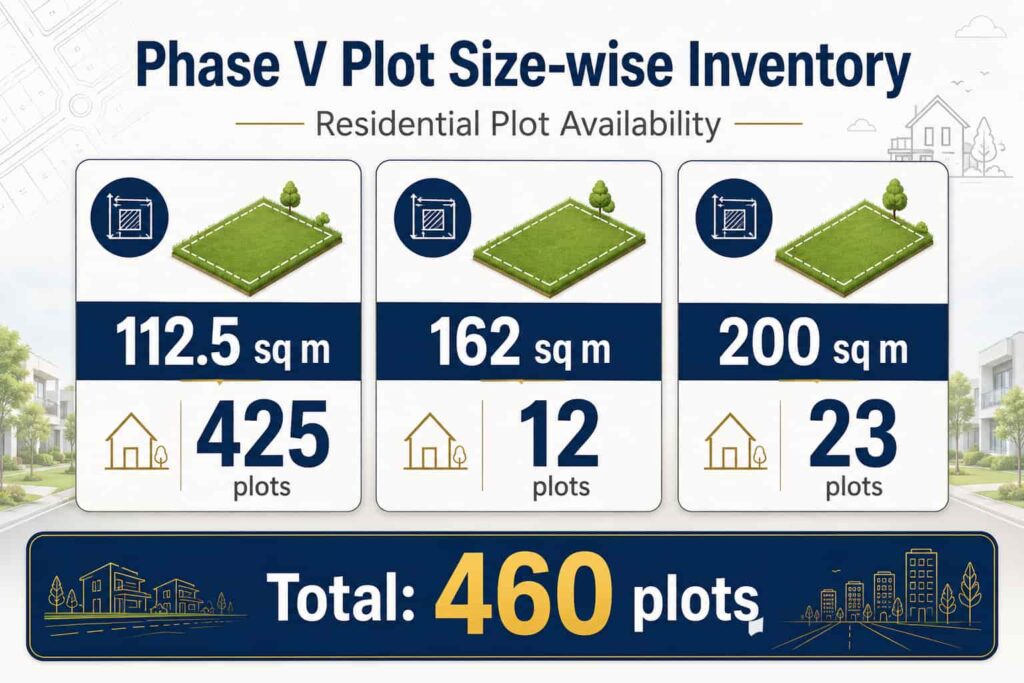

The current release has been reported at 460 residential plots, mainly in the smaller plot categories, with sizes ranging from approximately 112.5 sq m to 200 sq m.
The scheme is being allotted through a lottery process rather than FCFS.
LDA’s public page currently shows these general scheme terms. Buyers applying for the present Phase V should still check the current Phase V booklet and registration portal before calculating the final price because phase-specific terms should take precedence.
That is particularly important when a property purchase can run into several tens of lakhs.
Ashish Khand is separately registered with UP-RERA
The most useful official document for understanding the development timeline is the UP-RERA record.
The registered project location is Kaliya Kheda Pyarepur, Sarojini Nagar, Lucknow.
This 2030 completion date deserves attention.
Buying an LDA plot and buying into a fully mature neighbourhood are two different things.
A plot may be allotted much earlier, but roads, utilities, surrounding construction, commercial activity, institutions and neighbourhood occupancy can take years to reach maturity.
Phase V is only one part of a 785-acre township
This is where LDA’s project presentation changes the way Anant Nagar should be viewed.
The Authority is not presenting Anant Nagar merely as a collection of individual plots.
Its official project overview describes a 785.02-acre planned urban development with residential, educational and commercial uses.

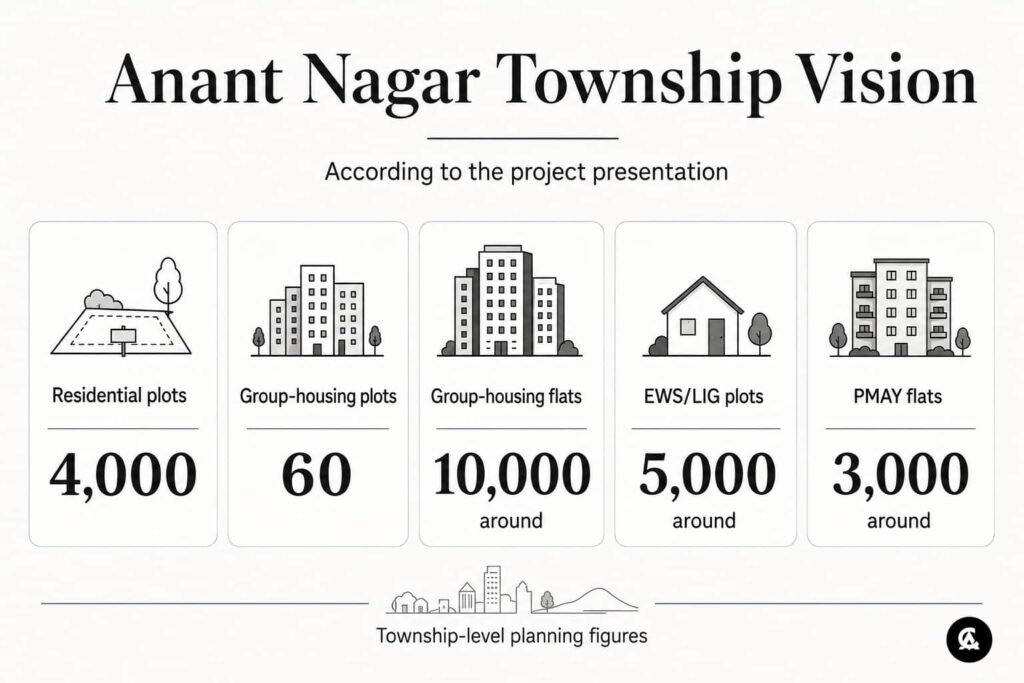

The LDA presentation further describes the township as being divided into eight khands, with different forms of housing and supporting infrastructure planned across the development.
These are township-level planning figures and should not be confused with the 460 plots being discussed under the current Phase V.
That difference is important.
Phase V is one sale/allotment phase. Anant Nagar is the larger township.
The 103-acre Education Hub could become one of Anant Nagar’s biggest anchors
One of the strongest elements in LDA’s presentation is a proposed 103-acre Education Hub.
The Authority describes it as a large integrated education zone intended to bring together facilities ranging from primary education to higher education.
The presentation also refers to:
- educational institutions;
- hostels;
- faculty accommodation; and
- capacity for roughly 10,000 students and teachers within the broader education ecosystem.
From a real-estate perspective, this matters.
A functioning education hub can potentially support:
resident population + rental demand + retail activity + transport demand + employment + daily footfall.
But buyers need to maintain one distinction:
planned education infrastructure is not the same as an operational education hub.
Until institutions are allotted, construction begins and campuses become functional, this should be regarded as part of the township’s future development proposition, not an existing neighbourhood advantage.
130 acres of parks make green planning a major part of the proposal
LDA’s presentation also proposes around 130 acres of land for parks and green areas.
The Authority’s official Anant Nagar housing page confirms that development objectives include parks, landscaping and infrastructure facilities, while the wider project is intended to support planned urban development.
The presentation additionally refers to a pond planned over approximately 1 lakh sq ft.
If executed at the proposed scale, 130 acres of open space would be an important planning feature for a 785-acre township.
But here again, buyers should distinguish between:
land earmarked in planning
and
landscaped parks that are actually completed and usable.
A master plan tells you what is proposed.
A site visit tells you what has actually happened.
60-metre and 45-metre roads are part of the planned road hierarchy
Another detail in the LDA presentation that deserves more attention is road width.

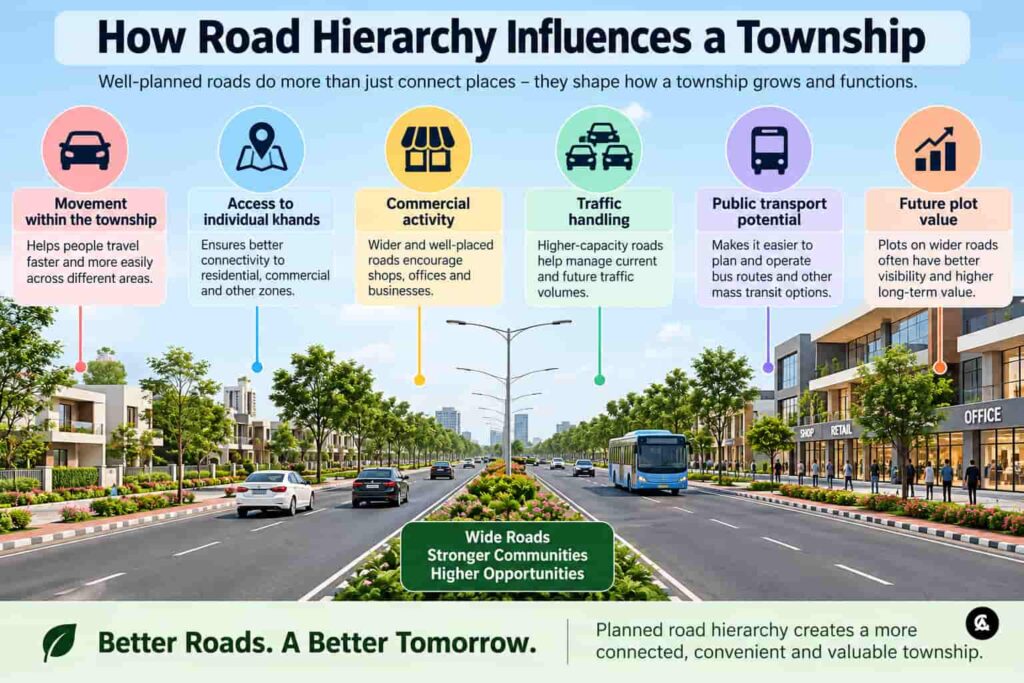

The township is proposed to follow a grid-pattern planning model, with major roads stated to be approximately 60 metres and 45 metres wide.
That can matter significantly in a plotted development
However, a buyer should verify the road width adjoining the exact plot, rather than assuming every plot in Anant Nagar sits on a 45-metre or 60-metre road.
Solar-enabled, zero-discharge and self-sustainable: What LDA is proposing?

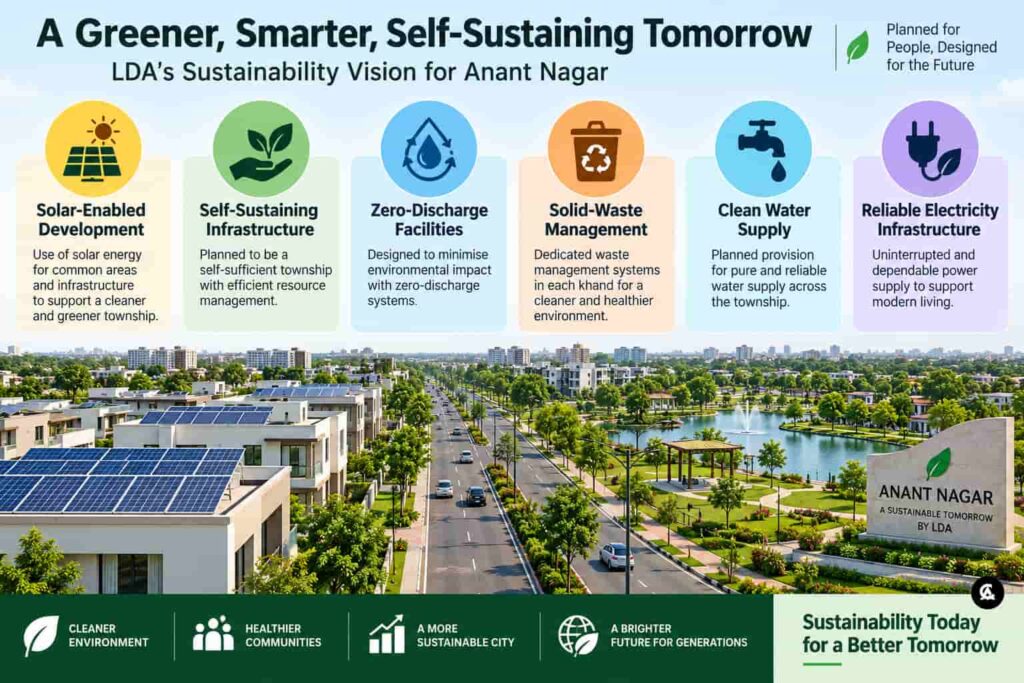

The project presentation gives Anant Nagar a strong sustainability positioning.
Among the planned features mentioned are:
The UP-RERA project record also shows that LDA has uploaded project documents relating to water supply, waste disposal and electricity supply for Ashish Khand.
That is useful evidence that utility planning forms part of the registered project’s documentation.
It does not, however, mean that every proposed sustainability feature is already completed.
For buyers, the right question is not:
“Has LDA announced solar and zero discharge?”
It is:
“What portion of this infrastructure has actually been tendered, constructed and commissioned in my khand?”
Connectivity is promising, but avoid the ‘few minutes away’ trap
But a promotional statement that destinations are “a few minutes away” should not become an investment fact without checking actual road routes.
The official RERA record places Ashish Khand at Kaliya Kheda Pyarepur in Sarojini Nagar, while LDA describes the wider project as being along the Mohan Road corridor.

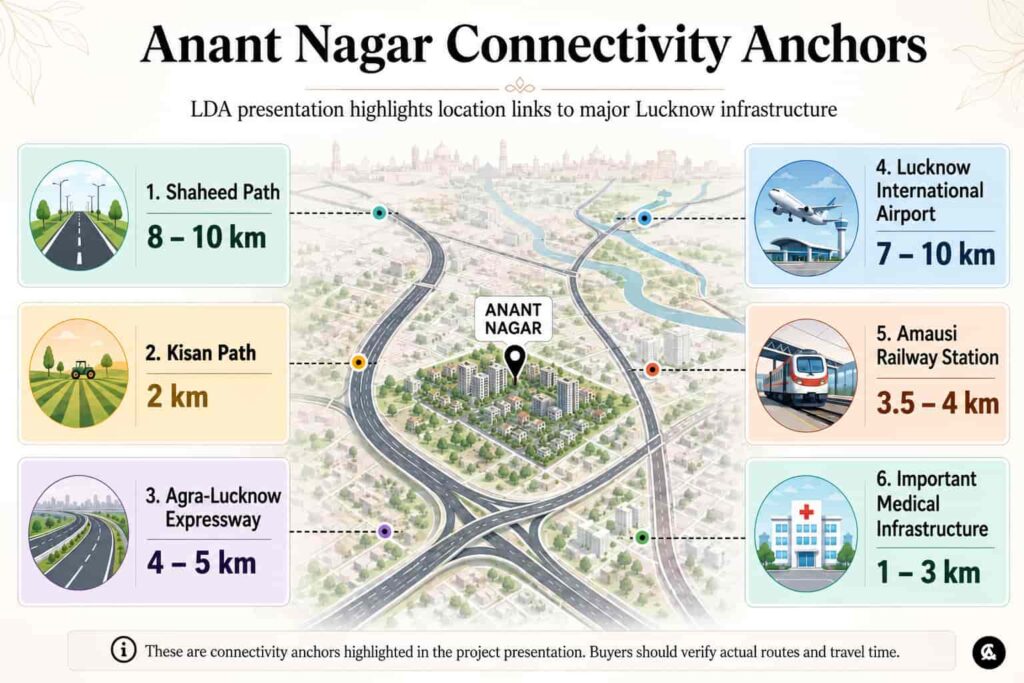

For a serious buyer, connectivity should be checked in three ways:

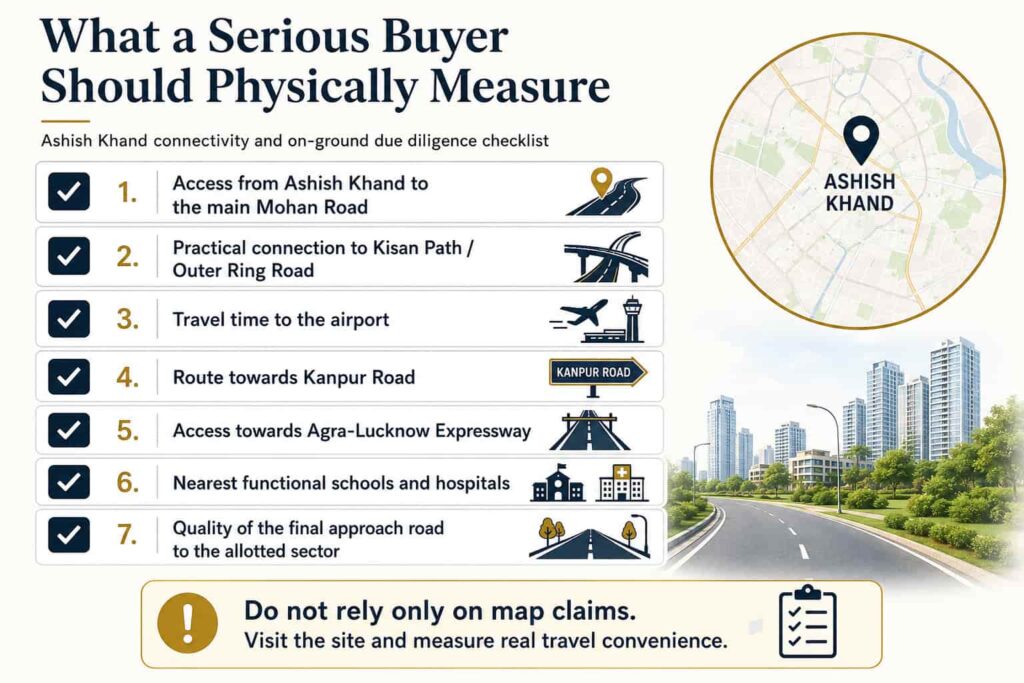

current road distance
peak-hour travel time
future proposed infrastructure
Do not mix all three.
A road or corridor proposed for the future may improve the development eventually, but it should not be valued as if it is already operational today.
Why the development timeline matters more than promotional scale
The size of Anant Nagar is impressive.
785 acres, eight khands, thousands of plots and flats, a 103-acre education zone, 130 acres of green space and major internal roads together create the picture of a substantial planned township.
But scale also means execution takes time.

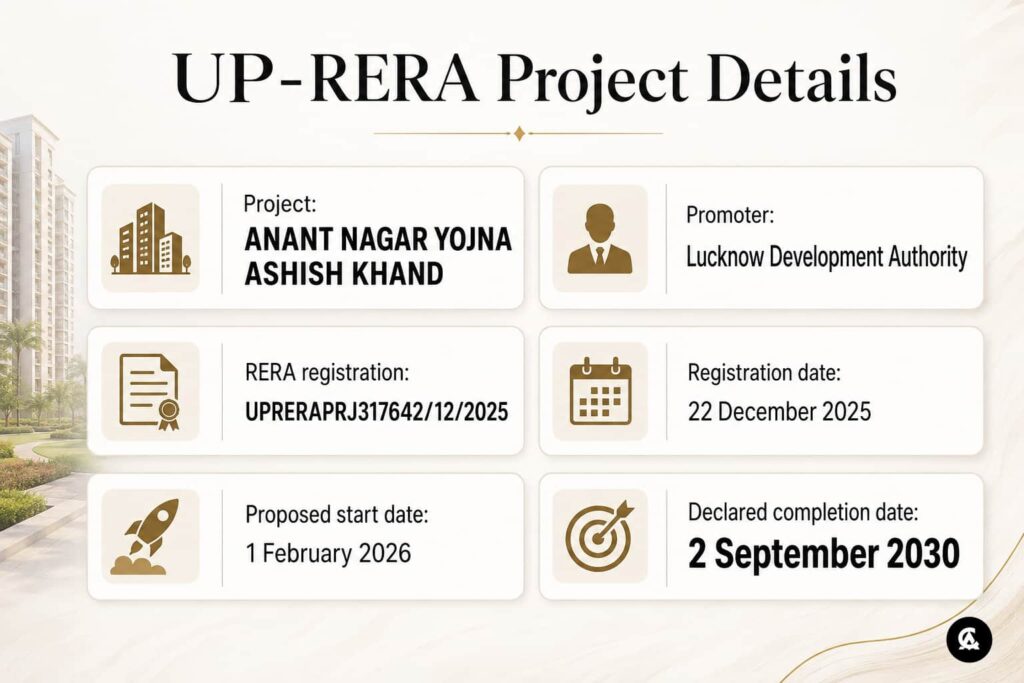

The RERA record gives Ashish Khand a declared completion date in September 2030.
For an end-user hoping to build quickly, that should shape expectations around:
- neighbourhood occupancy;
- nearby retail;
- school availability;
- public transport;
- road completion;
- street lighting;
- drainage;
- water systems;
- and surrounding construction activity.
For an investor, it means the investment thesis is likely to be linked to a multi-year development cycle rather than immediate neighbourhood maturity.
What does the RERA record say about complaints?
At present, UP-RERA displays zero complaints against this specific Ashish Khand project.
It separately lists complaints associated with LDA’s wider promoter portfolio, so the two numbers should not be confused.
The zero-project-complaint figure is useful as a current factual snapshot.
It should not be interpreted as a guarantee about future delivery.
The more important documents for a buyer remain the development schedule, approved plans, allotment terms and actual progress on site.
What can the final plot cost include beyond the basic rate?
One mistake buyers frequently make with authority plots is calculating:
plot area × base rate = total purchase cost.
The actual acquisition cost can be higher.

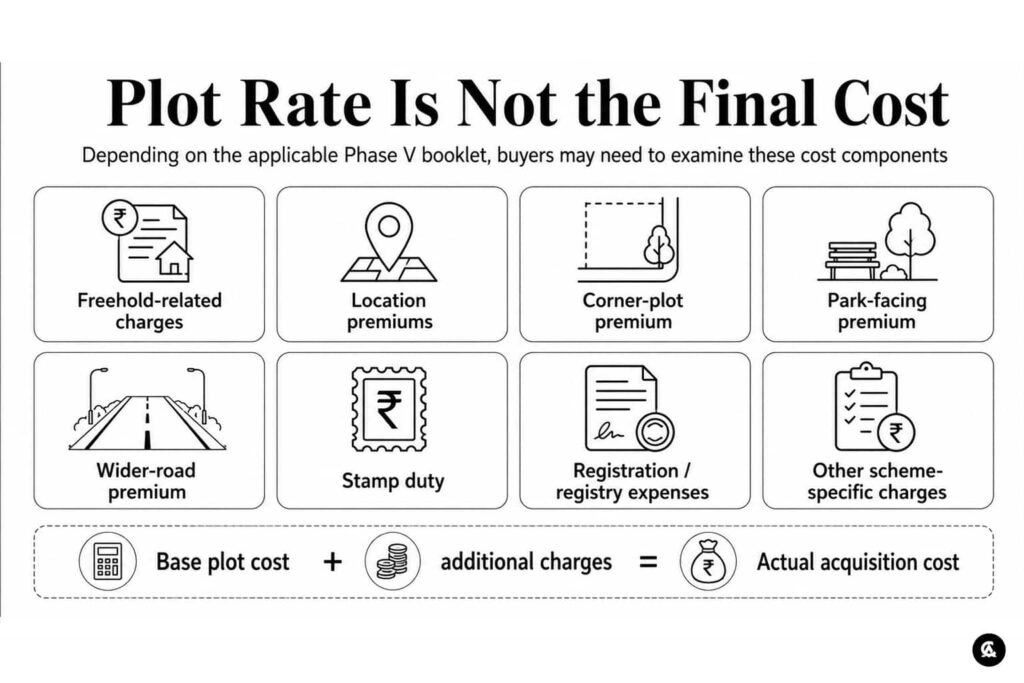

Depending on the applicable Phase V booklet, buyers may need to examine items such as:

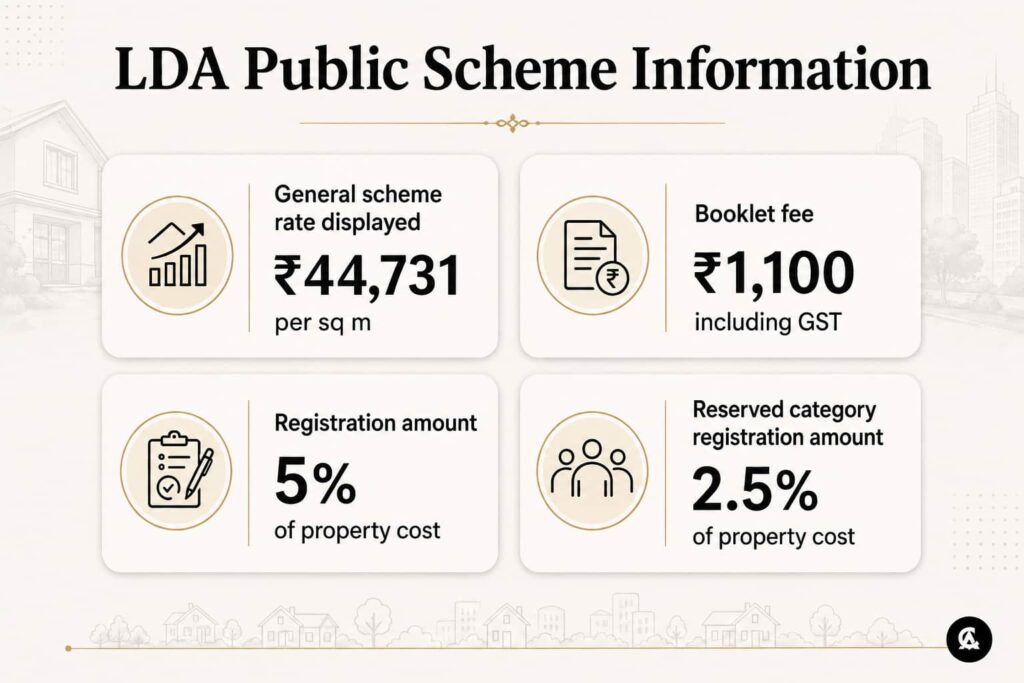

The public Anant Nagar page currently displays a rate of ₹44,731 per sq m, but the Phase V booklet should be checked before treating any publicly displayed general rate as the final controlling price for a particular plot.
That verification should happen before, not after, entering the lottery.

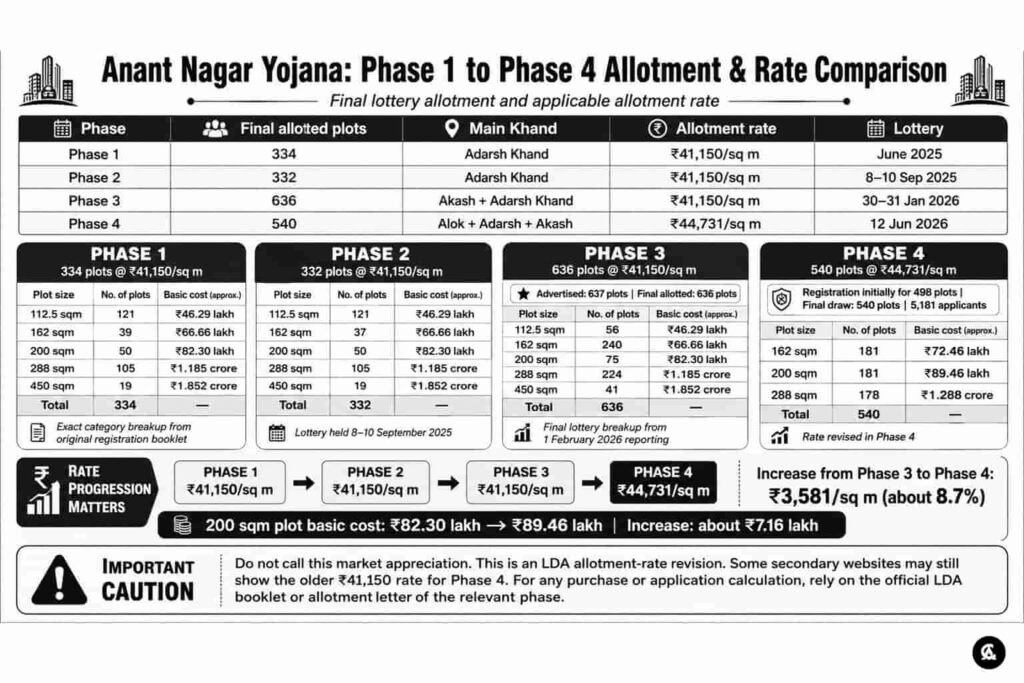

What do previous Anant Nagar phases tell us?

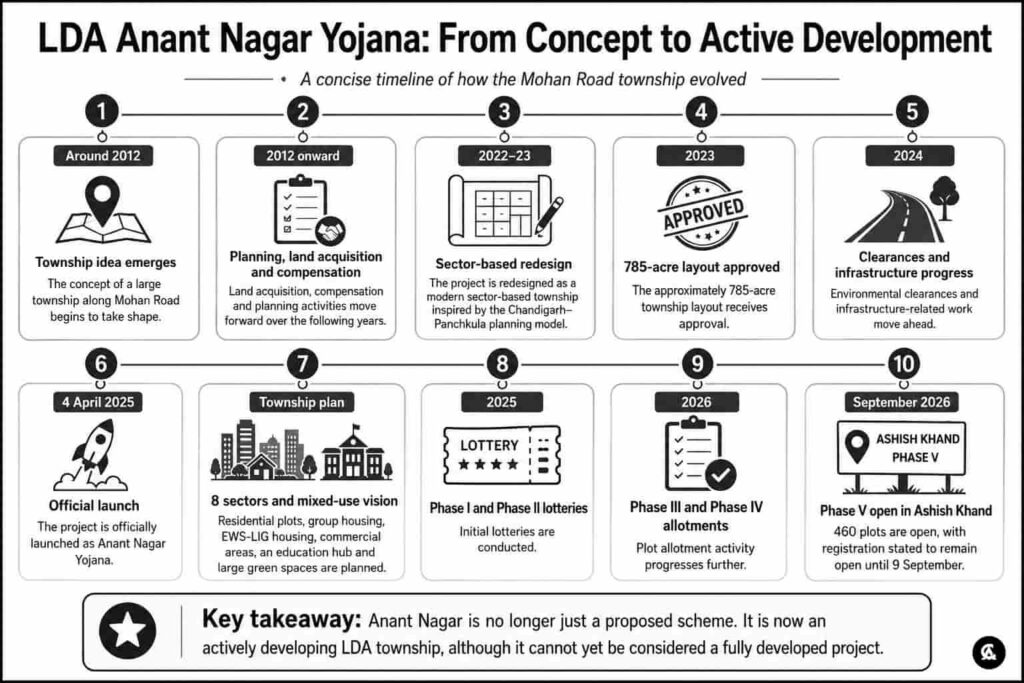

Anant Nagar is no longer at its first allotment cycle.
LDA’s official lottery records show Anant Nagar allotment activity across multiple phases, including draws in 2025 and 2026, covering plot categories from 112.5 sq m up to larger 450 sq m plots.
This tells buyers two things.
First, the township is being released in stages rather than all at once.
Second, Phase V should be understood as part of an ongoing development and allotment process.
But previous demand for LDA plots should not be converted into an assumption that prices will automatically appreciate.
Lottery demand measures demand for allotment at that point in time. It does not guarantee secondary-market returns.
For an investor, the thesis is different.
The attraction is:
LDA-backed planning + 785-acre scale + phased plot release + education/commercial components + long-term infrastructure development.
The risk is:
execution time + delayed neighbourhood maturity + future supply + holding cost + uncertain resale demand.
Neither the LDA name nor a 103-acre education hub should by itself be treated as a guarantee of appreciation.
The real story of Anant Nagar is bigger than Phase V
Phase V may bring buyers to Anant Nagar because of the current residential plot opportunity.
But the real reason the project deserves attention is its proposed scale.
LDA is planning Anant Nagar as an approximately 785-acre integrated urban development, rather than a standalone plotted colony. Its official project description confirms residential, educational and commercial planning, while LDA’s project presentation sets out a broader vision involving multiple housing formats, large green areas, major roads, sustainability features and a 103-acre education hub.
That vision can create long-term value — if execution follows planning.

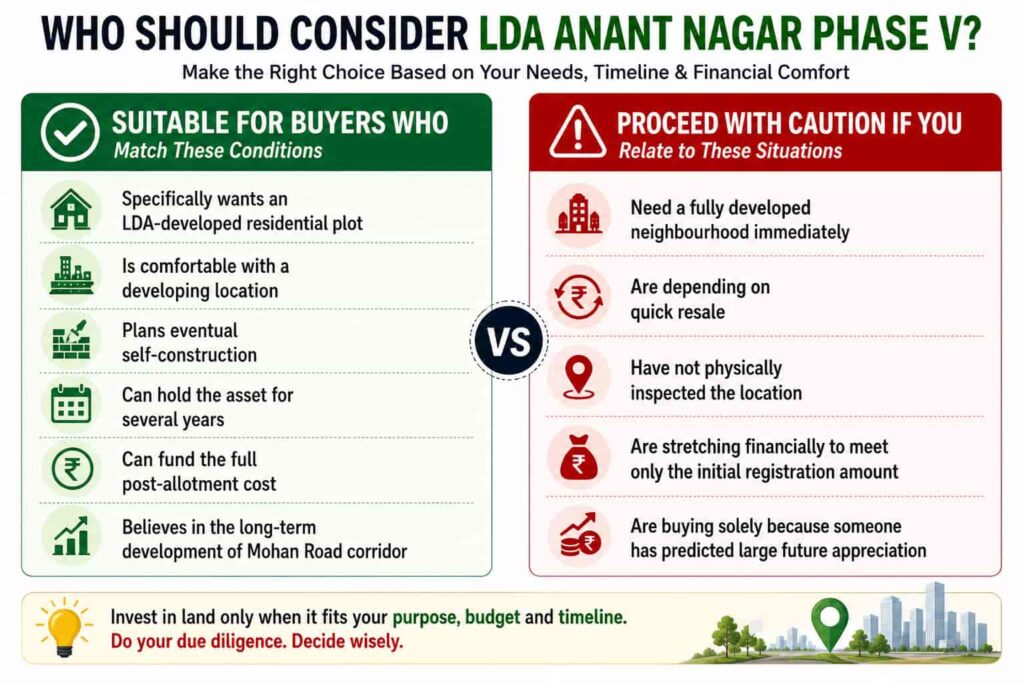

For a buyer in 2026, therefore, the correct approach is to evaluate two things separately:
the Phase V plot being offered today
and
the Anant Nagar township being promised for tomorrow.
A good real-estate decision requires both.
Sources
- Lucknow Development Authority — Anant Nagar Yojana Project Overview
Confirms the project is approximately 785.02 acres, along Mohan Road, and planned as a mixed residential, educational and commercial township.
Open official LDA Anant Nagar Project Overview - Lucknow Development Authority — Anant Nagar Housing Schemes
Contains the general scheme information, location details, ₹44,731/sq m general rate, ₹1,100 booklet fee, 5% registration amount, sector information and embedded Anant Nagar presentation/videos.
Open official LDA Anant Nagar Housing Schemes page - UP-RERA — Anant Nagar Yojna Ashish Khand
Official record confirming RERA No. UPRERAPRJ317642/12/2025, LDA as promoter, location Kaliya Kheda Pyarepur, Sarojini Nagar, proposed start 1 February 2026, and declared completion 2 September 2030.
Open official UP-RERA Ashish Khand project record - Lucknow Development Authority — Official Lottery Eligibility Records
Contains earlier Anant Nagar Phase I, Phase II, Akash/Adarsh Khand and Phase IV lottery records across different plot sizes.
Open official LDA Lottery Eligibility Records - Lucknow Development Authority — Official Lottery Results
Useful for checking successful allotments in earlier Anant Nagar phases.
Open official LDA Lottery Results page
